THE QUESTIONS THAT MATTER

SERIOUS QUESTIONS DESERVE DIRECT ANSWERS

These are the issues Gascoyne Green Energy’s own technical and commercial assessments identify as material, and where the Boolathana project’s work stands on each. Where work remains, we say so.

No. Boolathana’s competitiveness rests on the quality of its renewable resource, not on incentives.

Australia’s Hydrogen Production Tax Incentive was legislated in February 2025 and Boolathana would qualify, but GGE’s modelling shows the project’s economics remain viable at base pricing without it. The incentive accelerates payback and lifts returns; it does not enable viability. That distinction matters, because any policy remains subject to political and budgetary review.

Boolathana sits in north-west Western Australia, but well south of the Pilbara latitude where cyclone intensity concentrates. The Bureau of Meteorology’s long-term record for Carnarvon contains no public record of wind speeds exceeding 150 km/h, which supports IEC Class C turbine selection and standard insurance pricing.

Cyclone resilience remains a formal engineering and insurance diligence item, as it should be for any coastal infrastructure at this scale. The point is not that the site is immune – it is that its exposure is measurable rather than asserted.

Yes. The Western Australian government’s Diversification Lease framework is purpose-built to allow pastoral land to host new, compatible uses.

GGE holds a Section 91 licence under the Land Administration Act for the investigations the project requires, and exclusive access under a separate deed with the pastoral lessee running to December 2030, with a defined conversion to a Diversification Lease at the Final Investment Decision. The pastoralist release mechanism is agreed in principle. The residual variable is State Government timing on the lease award, not whether the pathway exists.

This is the central engineering question, and the answer is built from measured data rather than assumption.

The green ammonia plant is designed genset-free: no fossil-fuelled backup for its process load. That is possible because the site’s wind and solar are anti-correlated, so the combined resource is firm before storage is added. Across seven years of hourly data the longest continuous period of zero generation was twelve hours, and both the battery and the hydrogen store independently exceed that.

The honest caveat: a genset-free dispatch architecture at this scale has not been demonstrated in operation. The modelling draws on seven years of site data rather than design assumptions, and independent technical certification is the next step. This is first-of-kind operational risk, and GGE treats it as such.

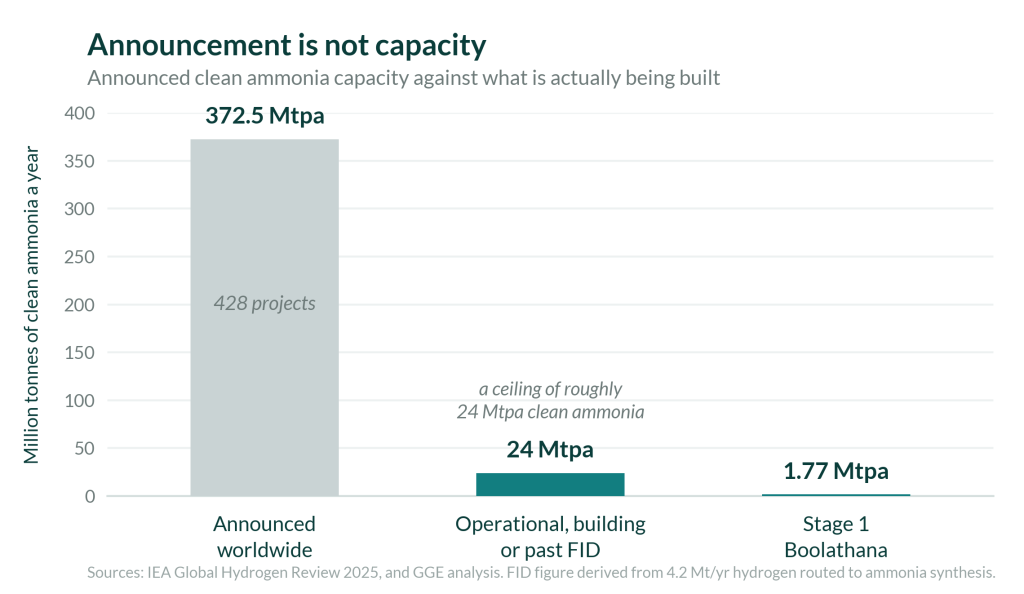

The Stage 1 plant is large, and the design responds through a two-train architecture rather than a single oversized unit. Each train sits within demonstrated single-train precedent – around three-quarters of the scale of the NEOM plant, which was approximately 80% constructed in early 2026 – and the second becomes a brownfield expansion within an operating facility.

Co-locating generation and processing on one title removes the transmission and coordination complexity that burdens dispersed projects. The underlying process carries no invention risk: electrolysis feeding Haber-Bosch synthesis is proven at the highest technology-readiness level. The risk is execution at scale, which staged delivery and independent certification are designed to manage.

Because at this scale there is no realistic alternative, and that is true of every utility-scale renewable project.

Chinese manufacturers hold dominant global supply share across wind turbines, solar, batteries and electrolysers, so competitive sourcing is a structural feature of the industry rather than a project-specific election. Boolathana’s off-grid configuration removes the grid-code compliance constraints that complicate such procurement elsewhere, and Australia imposes no anti-dumping tariffs on these categories. Commercial dialogue is established across all four categories, with Western alternatives identified as fallback for batteries and selected balance-of-plant.

On cost, in some markets, for a while. Blue ammonia – made from gas with carbon capture – is 60 to 70 per cent of clean ammonia capacity now at final investment decision or under construction, and it lands cheaper into Asia today. GGE plans around that rather than disputing it.

But blue’s low-carbon claim rests on upstream methane leakage, the hardest variable to control and the least regulated. At realistic capture and leakage rates blue sits above the carbon-intensity ceilings that certification regimes are converging on; green sits an order of magnitude below them. Three frameworks have tightened in two years – the EU’s RED III ceiling, the Carbon Border Adjustment Mechanism from 2026, and Japan’s subsidy threshold, now on a published path toward the European standard. The result is that roughly 55 to 80 per cent of practical clean ammonia demand by 2035 sits where green is favoured or blue is excluded.

The clearest signal comes from buyers. Several major Japanese trading houses have begun writing green-optionality clauses into blue contracts, taking the right to substitute green at parity. They are pricing blue’s policy risk themselves. Boolathana’s position does not depend on that shift: its modelled cost is competitive with blue before any policy support is counted.

Sodium-ion storage is at an earlier stage of commercial deployment than lithium-ion, and Stage 1 specifies it. Two things make that a considered choice rather than a gamble: major manufacturers including CATL and BYD are scaling sodium-ion production now, and an off-grid application is less demanding than grid-scale service. Lithium-ion remains available as a fallback at higher cost, so the project does not depend on the technology maturing to a particular timetable.

The first year of baseline flora and fauna work is complete, including a shorebird survey, and the second-year programme is under way. A Red Flag Multi-Criteria Assessment by Preston Consulting found no constraint that would, on a desktop basis, preclude the project, and coastal and marine baseline work is supported by completed metocean studies.

A 5 GW wind build adjacent to 23 km of coastal frontage properly requires comprehensive avifauna, marine and cultural-heritage assessment, and that is what the programme is designed to deliver. Referral under Commonwealth environmental law follows completion of the second-year baseline, with State approvals running concurrently.

The honest position: formal assessment may identify matters requiring extended timelines or design modification. That is a normal development-stage exposure, not a fatal constraint – and the site’s scale and uniform terrain give real flexibility to site infrastructure away from sensitive areas.

No, and GGE does not claim otherwise. No binding agreements are in place for Boolathana.

Worth knowing what that means in context. Across the whole sector, every secured green ammonia offtake in the public record is either government-underwritten or sold to a buyer holding equity in the project. NEOM’s thirty-year agreement is with Air Products, one of its three equal partners. The two contracts with disclosed prices — Egypt’s into the EU’s H2Global mechanism, and India’s SECI packages — are both policy-backed. Genuinely arm’s-length offtake, signed by an independent buyer at a disclosed price, is close to absent industry-wide. Breadth of market interest is not the same as bankable, priced demand, and GGE does not present it as such.

Industry-wide, signed offtake covered 1.7 Mtpa of hydrogen in 2024, down from 2.4 Mtpa in 2023, and only a fifth of those were firm agreements.

Engagement is under way with buyers acrossEngagement is under way with buyers across Europe, Japan and Korea, and offtake formation is a gating condition for the investment decision — the project proceeds only if delivered pricing is competitive. Australia’s own nitrogen market provides a nearer-term layer: mining explosives, urea import substitution, and AdBlue resilience, all against a shrinking domestic production base.
